Beacon Hill residents along 21st Avenue S have been waiting a long time for sidewalks.
Situated about halfway between Seattle’s Beacon Hill and Mount Baker light rail stations, 21st Avenue is close to several schools and can become a major thoroughfare close to school pick-up and drop-off times. Given the roadway’s slope, the street often floods when stormwater accumulates from further up the hill, and many homeowners along 21st have taken measures to protect their homes from flooding, including building rock walls and adding asphalt berms.

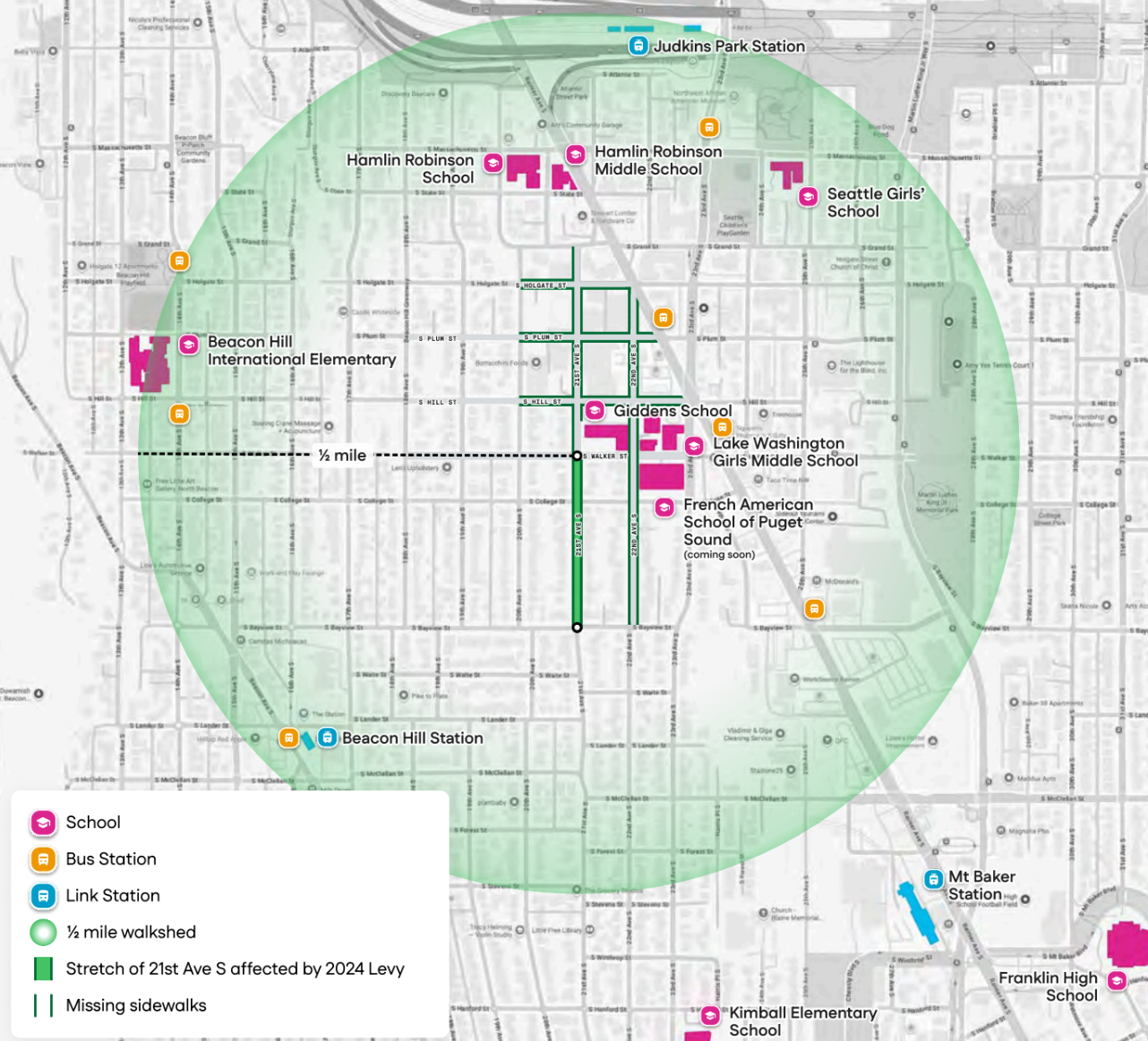

South of Bayview Street, sidewalks have been in place along 21st since the late 1960s, but north all the way to Rainier Avenue, longtime residents have spent decades walking without sidewalks or benefitting from proper curbs and drainage. The newly built Giddens School, which moved to Beacon Hill from the Central District in 2019, was required to add sidewalks in front of the school, but they sit disconnected from the broader sidewalk network.

Four blocks north of the Giddens School is the recently completed Grand Street Commons, a mixed-income apartment complex that added 569 homes to the neighborhood when it was completed in 2024. The builder added new sidewalks on the immediate blocks, but the City has not connected them to the nearby elementary school.
21st Avenue is just the type of area that Seattle’s 2024 transportation levy was intended to benefit, with voters approving a record amount of funding to build new sidewalks. On top of $111 million dedicated to expand the city’s sidewalk network, the $1.55 billion levy also includes millions more for sidewalks as part of neighborhood traffic safety projects.
However, since Seattle is missing sidewalks on around 11,000 of the blocks citywide — around a quarter of all blocks — the plan for 21st Avenue S comes with a catch.
Rather than a full curb-and-gutter sidewalk, built using concrete, the Seattle Department of Transportation (SDOT) plans to install an asphalt pathway along the west side of 21st, separated from the street by precast concrete wheel stops. This is the type of sidewalk typically seen in commercial parking lots. The project was included in the first tranche of sidewalk projects included in SDOT’s 2025 levy delivery plan, along with around 20 other projects set to start construction by the end of this year.
To Dana Lee, who moved to 21st Avenue with her husband Dan in 2019, that plan doesn’t fulfill the implicit promise that the city made when it started installing sidewalks in the neighborhood 50 years ago. She has been advocating for a full sidewalk, after initially spending years just trying to get the issue of building sidewalks on 21st onto the city’s radar.

As a non-arterial, or neighborhood street, 21st Avenue is far from alone in being slated for a more quick-build treatment for new sidewalks. An innovation developed during the previous transportation levy, 2015’s Levy to Move Seattle, SDOT has built dozens of lower-cost “pathways” or “sidewalk alternatives” over the past decade in the hopes of making bigger inroads in bridging gasps in the sidewalk network. For the most part, new concrete sidewalks have been reserved for arterial streets, the busiest corridors in the city where transit routes and businesses are concentrated.

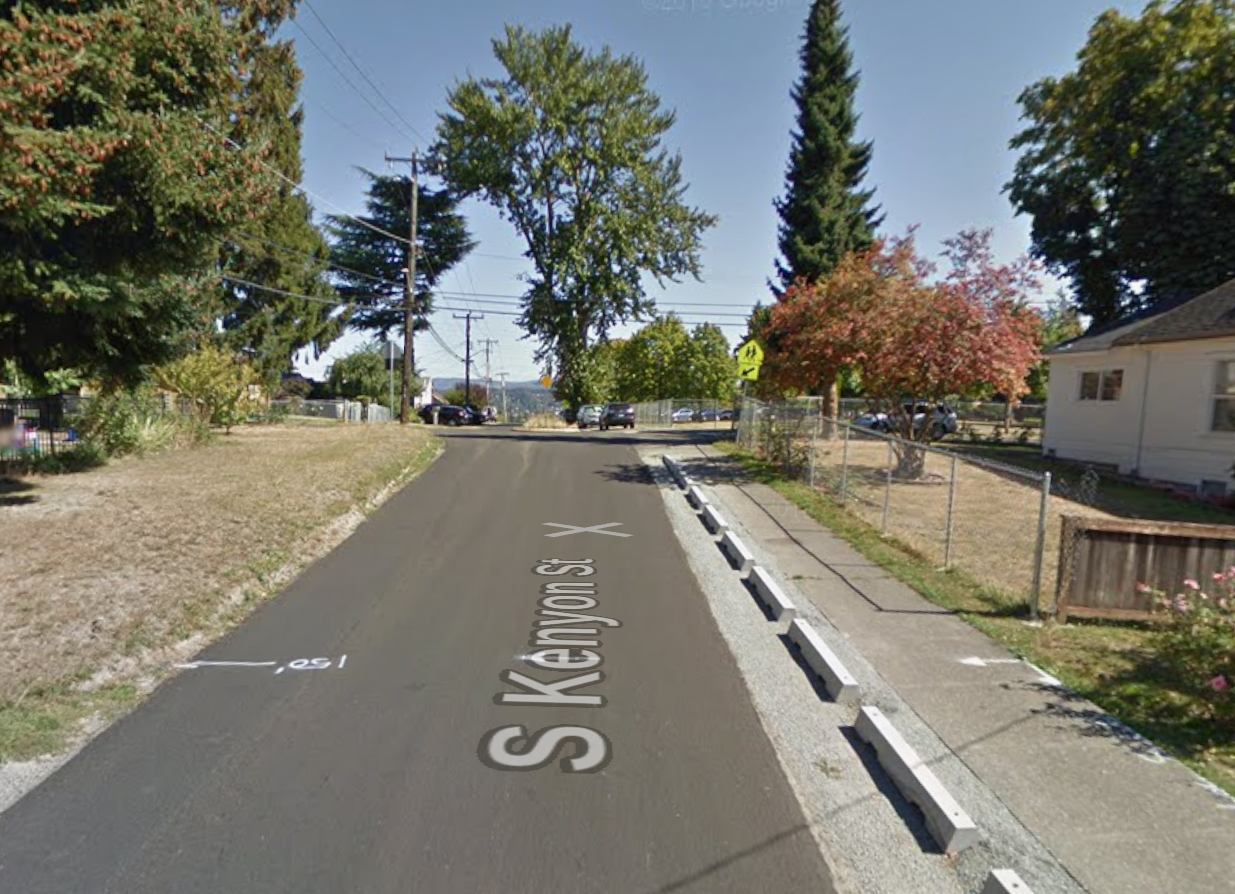

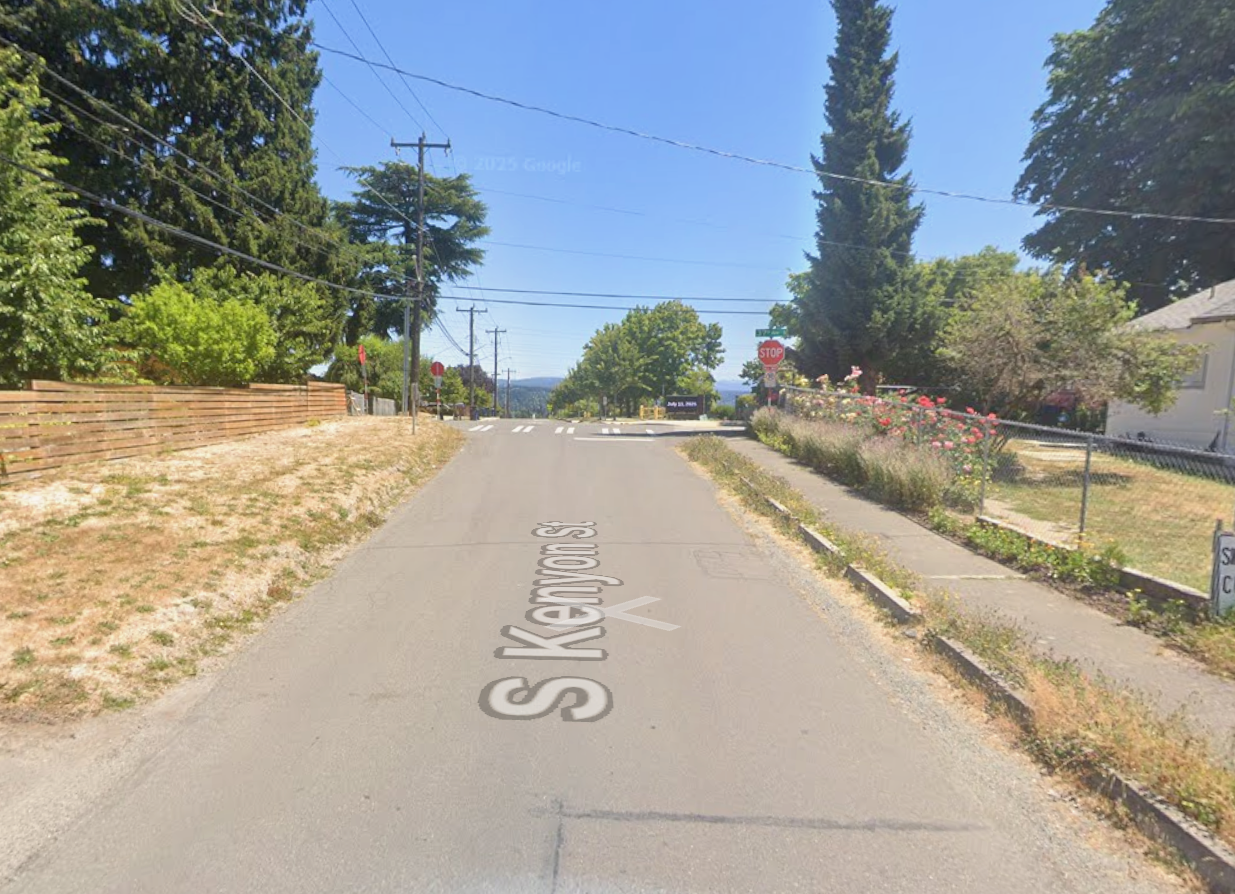

But Lee sees the plan for an asphalt pathway as shortchanging the neighborhood, continuing a pattern of disinvestment. She points to other low-cost pathways that were installed throughout South Seattle during the Levy to Move Seattle era that have started to deteriorate after less than a decade of use. Elsewhere in Beacon Hill, along a stretch of S Kenyon Street near Beacon Avenue, the wheel stops have started to be swallowed up by weeds, and vegetation growth has narrowed the effective width of the sidewalk, potentially falling short of Americans with Disabilities Act [ADA] standards.
