SDOT Budget Cuts Miss the Point

Ray Dubicki - June 25, 2020
Whether Seattle’s two streetcar lines should finally be connected took center stage at the city council’s budget discussions on Friday. (Photo: Doug Trumm)

On Wednesday, the Seattle Department of Transportation (SDOT) announced a series of “paused” transportation projects to respond to the economic fallout from the Covid epidemic. The delayed projects cover many corners of the city and some parts of the transportation budget, including six Bicycle Master Plan projects, the perennially besieged Center City Connector Streetcar, and the long-promised pedestrian-focused green street on Thomas Street. Director Sam Zimbabwe called the cuts “thoughtful, but immediate action.” The cost savings from stopping the projects is $58.3 million or 8% of SDOT’s $739 million adopted budget.

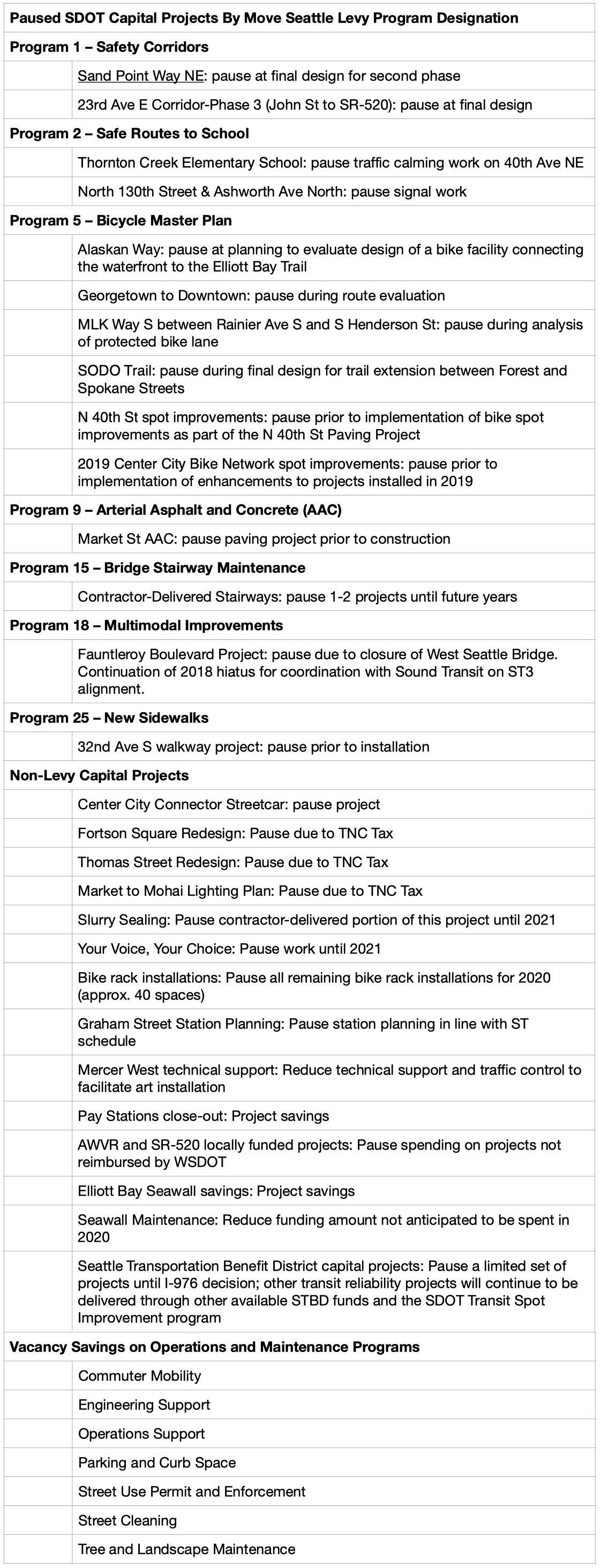

As of today, the following Levy projects are paused until January 2021, and/or pending a final decision in conjunction with the 2021-2022 budget process, sorted by Levy program: Program 1 – Safety Corridors o   Sand Point Way NE: second phase of this project, including new sidewalks, is paused at final design before advertising construction contract o   23rd Ave E Corridor-Phase 3 (John St to SR-520):  project paused at final design before advertising construction contract Program 2 – Safe Routes to School o   Thornton Creek Elementary School: pause traffic calming work on 40th Ave NE o   North 130th Street & Ashworth Ave North: pause signal work Program 5 – Bicycle Master Plan o   Alaskan Way: this project was funded to evaluate design of a bike facility connecting the waterfront to the Elliott Bay Trail; planning work is paused o   Georgetown to Downtown: project paused during route evaluation o   MLK Way S between Rainier Ave S and S Henderson St: project paused during analysis of protected bike lane o   SODO Trail: project paused during final design for a SODO trail extension between Forest and Spokane St o   N 40th St spot improvements: this work is paused prior to implementation of bike spot improvements as part of the N 40th St Paving Project o   2019 Center City Bike Network spot improvements: this work is paused prior to implementation of enhancements to projects installed in 2019 Program 9 – Arterial Asphalt and Concrete (AAC)   o   Market St AAC: pause paving project prior to construction Program 15 – Bridge Stairway Maintenance Contractor-delivered stairways: pause 1-2 projects until future years Program 18 – Multimodal Improvements  o   Fauntleroy Boulevard Project: this project was paused in 2018 to allow SDOT and Sound Transit to coordinate while Sound Transit develops the Link light rail preferred alignment and construction timeframes. With the addition of the unplanned closure of the West Seattle High-Bridge and the associated timeline, it is no longer an appropriate time to perform the scope of work identified in the Fauntleroy Boulevard Project. SDOT remains committed to the improvements in the long term, as funding and other adjacent projects allow Program 25 – New Sidewalks o   32nd Ave S: walkway project paused prior to installation In addition, the following non-Levy capital projects are paused: o   Center City Connector Streetcar: pause project  o   Various projects dependent on TNC Tax Revenues: Market to MOHAI (delay Phase 2 of pedestrian lighting project), ,Thomas St Redesign (pause design at 30%), Fortson Square Redesign (pause design; public realm plaza would not be completed in 2021) o   Slurry Sealing: pause  contractor-delivered portion of this project until 2021 o   Your Voice, Your Choice: pause work until 2021 o   Bike rack installations: pause all remaining bike rack installations for 2020 (approx. 40 spaces) o   ST3 Planning and Design: defer Graham St Station Planning in line with ST schedule o   Mercer West technical support: reduce technical support and traffic control to facilitate art installation o   Pay Stations close-out: project savings o   AWVR and SR-520 locally funded projects: pause spending on projects not reimbursed by WSDOT o   Elliott Bay Seawall savings: project savings o   Seawall Maintenance: reduce funding amount not anticipated to be spent in 2020 o   STBD capital projects: Pause a limited set of projects until I-976 decision; other transit reliability projects will continue to be delivered through other available STBD funds and the SDOT Transit Spot Improvement program
Several programs are getting cut, which is presented as a pause, but that is pending future funding. Center City Streetcar work may represent the largest cut. (Seattle Department of Transportation)

In his message accompanying the list of cuts, Director Zimbabwe said the pauses allow for SDOT to “understand our fiscal constraints, identify immediate cost savings to address budget shortfalls, and establish a thoughtful, equity-first process for 2021 and beyond.”

The department highlighted projects that will continue, many of which are in advanced stages of construction. Automobile bridges like the Lander Street Overpass and Fairview Bridge Replacement, bike facilities on MLK Way north of Rainier and from Georgetown to South Park, and Rapid RideH Line in Delridge and RapidRide G Line in Madison will all continue, as is construction of the Northgate Bike and Pedestrian Bridge.

A number of holds are on projects that were moving ahead of their projected need. Planning for Sound Transit 3 (ST3) at Graham Street is paused to move in line with the Sound Transit schedule for the station’s opening in 2031. This comes after the community’s push to get the infill station on ST3. The West Seattle Bridge repair or replacement will itself continue, whatever form that may take. However, the dependent Fauntleroy Boulevard Project that was already paused for ST3 will continue to be delayed until the West Seattle Bridge is sorted out.

A group of “paused” projects are reliant on funding from other sources. Seattle was supposed to bring in $8.9 million in 2020 from the new ridehailing tax. Numbers have not been released on how Covid is impacting this 57 cent tax on every Lyft and Uber trip, but the companies are not faring well and Heidi Groover has reported revenues are expected to be half of expected. Projects based on that tax have been paused, including lighting from Pike Place Market to MOHAI, and redesigned street projects on Fortson Square and Thomas Street–which was a signature bike and pedestrian upgrade meant to accompany the SR-99 tunnel and new Seattle Center Arena.

While the text of Director Zimbabwe’s message emphasizes the pedestrian and transit projects that will continue, it belies the underlying preference for automobiles that are written into the SDOT budget to begin with. The value of the Lander Street overpass exceeds the entire 2020 Levy to Move Seattle budget. The 3,900 miles of street lanes in the city cost $61 million per year in maintenance and another $38 million goes to bridges and structures. Everything else–sidewalks, signs, bike paths, and trails–costs about $7 million in maintenance. Pardon if four more miles of Open Streets seems small. It is also unclear what the impact of “vacancy savings” will be on divisions like Street Use Permit and Inspections when neighborhoods and Councilmembers are fighting to open right-of-way to restaurants and retail uses.

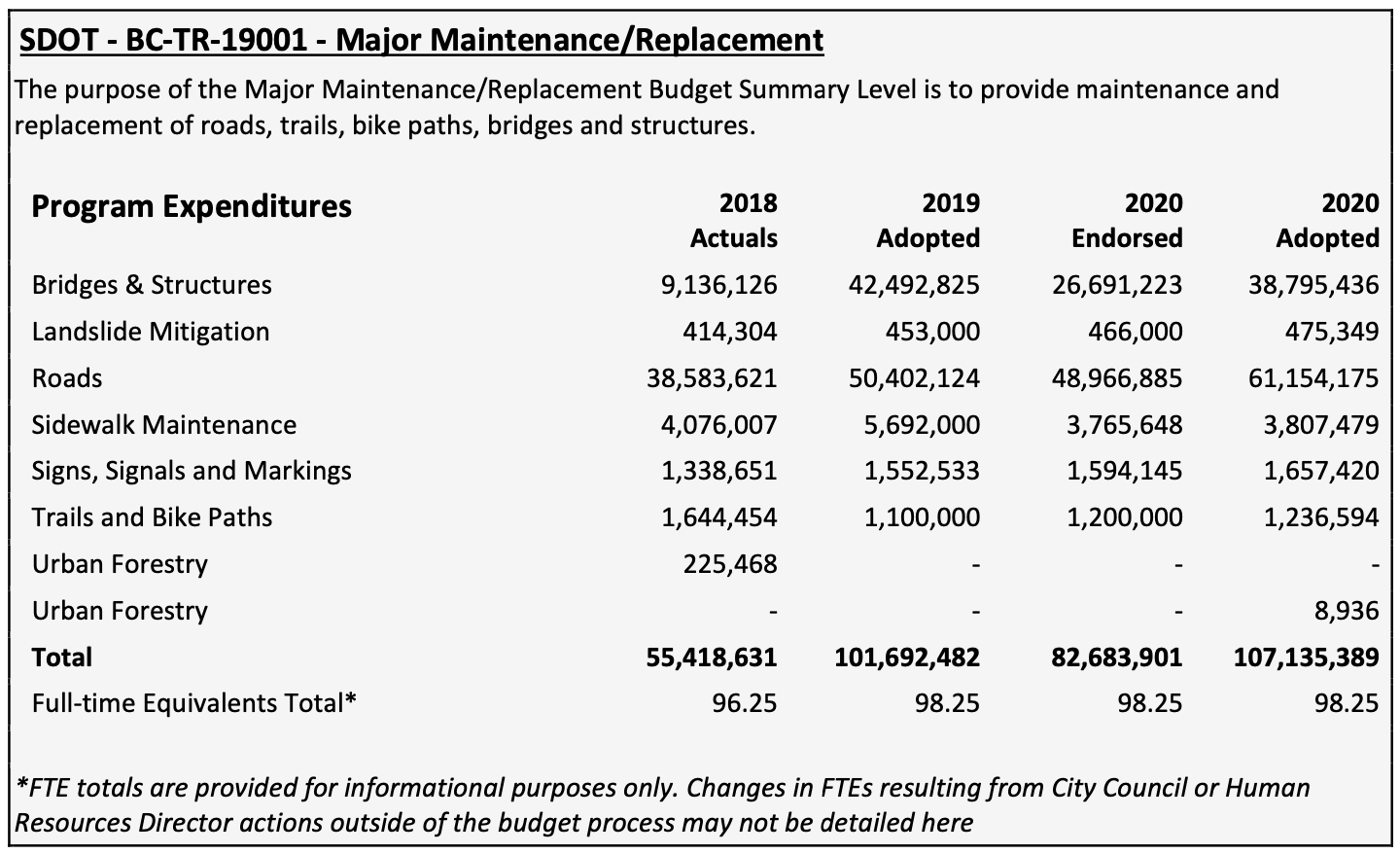

Roads get $61.15 million and Bridges & Structures $38.8 million in the 2020 adopted SDOT budget for "Major Maintenance/Replacement."
Excerpt of the 2020 Approved SDOT budget showing program expenditures for maintenance of roads, sidewalks, and paths representing 1/7 of the department’s budget. (City of Seattle)

More than a quarter of the 2020 Move Seattle Levy funds, $38 million of $141 million, is just maintaining Arterial Roadways. All of those projects will continue except the NW Market Street repaving, which some community members were asking to be put on hold. The second largest part of the levy budget, $12.1 million in 2020, is multimodal improvements. These fall under Congestion Relief, and involve improving bus transit within a network of free flowing automobiles.

Even in third place at 10% of the Levy budget, bike lanes get the longest list of cuts. Six Bicycle Master Plan projects are paused: two spot repairs and four projects paused in planning phases. The balance through the city is not very equitable–the Alaskan Way project is in Downtown (promised as part of the $4 billion viaduct replacement project) and the other three–MLK, Georgetown, and SODO–are in South Seattle. Together they total seven miles of bike lanes, which exceeds the number of bike lanes that have been built in any year of the Move Seattle Levy.

Like many SDOT projects, bike lanes are almost never just bike lanes. Many involve repairs to automobile road surfaces and signalization to merely accommodate the bicycles in car space. Infrastructure like the Northgate Pedestrian Bridge is literally just separating the problem of pedestrians from the highway instead of reconsidering the existence of such an impassible barrier.

A bike lane is never just a bike lane. The complete rebuilding of NW Market Street in 2019 to allow for the construction of the Burke Gilman Missing Link (Photo by Ray Dubicki)

For projects not based on the Move Seattle Levy, the headline “pause” is the Center City Connector Streetcar. Re-approved by the City Council for a $9 million design budget after a long hiatus, the project to connect the city’s two existing streetcar lines through downtown was just getting restarted and targeted a 2026 opening. Given the Durkan administration’s delays and antagonism towards the streetcar, it appears that Covid is a convenient excuse to kill the project, and long-time streetcar critic Councilmember Lisa Herbold said her intent was not a pause but to kill the project during Budget Committee on Wednesday.
